Scope creep isn’t a client problem—it’s a structure problem. The cure is a short, testable scope of work upwork plus outcome-named milestones with explicit acceptance criteria (“Done = …”). In this guide you’ll get ready-made clauses, a fill-in change request template, and lane-specific milestone blueprints so your projects end on time, on budget, and without drama.

Why milestones are your best defense

On Upwork, buyers often arrive with fuzzy briefs and tight timelines. If you don’t pre-define outcomes, every new idea feels “included.” That’s how upwork milestones scope creep sneaks in: tiny, “reasonable” asks that snowball.

Milestones fix this by making the project decidable:

  1. Name by outcome, not effort. “Fix Pack & Validation” beats “Week 1.”

  2. Write acceptance criteria in buyer language.Done = PDP LCP < 2.8s & CLS < 0.1; before/after screenshots; rollback notes.”

  3. State what’s not included. List out-of-scope in one visible block.

  4. Embed change control. Requests don’t get rejected; they get routed through a clear lane (swap/extend/hourly).

That’s smart milestone planning upwork—calm projects, fewer disputes, stronger reviews.

The minimum viable Scope of Work (SOW) for Upwork

Keep it crisp—phone-length where possible. Paste this into your proposal or first milestone.

SOW sections (copy & adapt):

  • Objective: The business problem and the outcome you’ll deliver.

  • Deliverables: Artifacts the client receives (code, prototype, audit report, Loom walkthrough).

  • Acceptance Criteria: A bold Done = … line written in the client’s words.

  • Out of Scope: Explicit list to fence-in work.

  • Assumptions & Dependencies: Access, tools, data, decision-maker availability.

  • Timeline & Cadence: Duration, working hours/overlap, update rhythm.

  • Revisions / Iterations: What’s included; what triggers change control.

  • Change Control: Route for new asks (see template below).

  • Warranty & Support: Short stabilization window after delivery.

Include this in every scope of work upwork and you’ll solve 80% of creep before it starts.

SOW Section Purpose / What to Include
Objective Describe the business problem and the exact outcome you will deliver.
Deliverables List the artifacts the client receives (code, prototype, audit report, Loom walkthrough).
Acceptance Criteria Add a bold “Done = …” line written in the client’s own words.
Out of Scope Explicit list of what is not included to prevent scope creep.
Assumptions & Dependencies Access, tools, data, and decision-maker availability that the timeline relies on.
Timeline & Cadence Duration, working hours/overlap, and update rhythm for the project.
Revisions / Iterations Number of revision cycles included and what triggers change control.
Change Control Clear route for new asks (swap, extend, or explore options).
Warranty & Support Short stabilization window after delivery and conditions for ongoing support.

Ready-Made Clauses (plug-and-play)

Use these verbatim and tweak the bracketed parts.

1) Outcome & Acceptance Criteria

Outcome: Improve {{area}} so {{business impact}}.
Done = {{metric or artifact}} on {{pages/templates/flows}} with {{evidence}}. Example: Done = PDP mobile LCP < 2.8s & CLS < 0.1 verified in Lighthouse; before/after screenshots; rollback notes.

2) Out of Scope (Fence)

Out of scope: rebrands, net-new features, unrelated bug backlogs, migration to new platforms, third-party fees, copywriting beyond listed pages, legal/compliance sign-off.

3) Assumptions & Dependencies

Assumes read-only access to {{tools}}, one decision-maker for approvals, and content/assets supplied by {{date}}. Delays extend timeline 1:1.

4) Revisions / Iterations

Includes {{n}} revision cycle(s) scoped to the deliverables. New features or changes beyond acceptance criteria follow the Change Control process.

5) Change Control (Swap / Extend / Explore)

New requests are welcomed and routed via the Change Request lane:
Swap equal effort within the existing milestone.
Extend by adding a new milestone.
Explore via a capped hourly micro-sprint to size the work.

6) Warranty & Support

Stabilization window: {{7–14}} calendar days after acceptance for regressions related to delivered work; excludes new features or third-party changes.

7) Risk & Rollback

Changes ship behind feature flags or branches. If adverse impact is detected, we rollback within {{X}} hours and propose alternatives in the decision memo.

These clauses make upwork milestones scope creep far less likely because every request has a home.

The Change Request Template (fill-in)

Drop this into your messages or attach as a quick form.

Change Request (CR)
Requested by:
{{client name}} • Date: {{YYYY-MM-DD}}
Title: {{concise request name}}
Description: {{what changed / what you want}}
Reason/Impact: {{why now; risk of not doing}}
Options (choose one):
A) Swap:
Replace {{task A}} with {{task B}} inside current milestone (equal effort).
B) Extend: Add Milestone {{N+1}}: Done = {{acceptance criteria}} • Estimate: {{days}} • Price: {{$}}.
C) Explore: Hourly cap {{hours}} to size and propose.
Decision by: {{date}} • Approved by: {{name/signature}}.

You’re not saying “no”—you’re offering structured choices. That’s how a change request template keeps scope honest without killing momentum.

Milestone Blueprints by Lane (ready to paste)

Each blueprint includes a name, acceptance criteria, artifacts, and exclusions. Tweak numbers to fit.

Web Development (Performance/CWV)

  • M1 — Fix Pack & Validation
    Done =
    PDP/PLP mobile LCP < 2.8s, CLS < 0.1 on 3 test pages; before/after screenshots; rollback notes.
    Artifacts: PR links, Lighthouse runs, 90-sec Loom.
    Out of scope: redesigns, new third-party apps, copy changes.

  • M2 — Template Hardening
    Done =
    refactor shared components to keep metrics green across PDP/PLP/Home; synthetic checks added.

UI/UX (Dashboard v1)

  • M1 — Decisionable Prototype
    Done =
    mid-fi prototype of 3 core flows + 5 unmoderated tests ≥ 80% task success; 1-page decision memo.
    Artifacts: Figma link, test notes, memo.
    Out of scope: production-ready UI kit, dev build.

  • M2 — Handoff & Specs
    Done =
    annotated flows + component specs; dev Q&A Loom.

SEO (Technical + CWV)

  • M1 — Indexation & CWV Audit
    Done =
    index bloat triaged; canonical policy; CWV deltas on {{templates}} verified in GSC.
    Artifacts: audit doc, prioritized fixes.

  • M2 — Fix Pack
    Done =
    implement top {{n}} fixes; validation plan; re-run metrics.

Content (B2B)

  • M1 — Outline-First Article
    Done =
    approved H2/H3 outline + sources within 48h.
    M2 — Draft & QA
    Done =
    1,200-word draft in voice; two internal links; fact check pass.

Data/AI (Churn Baseline)

  • M1 — Model & Decision Memo
    Done =
    macro-F1 ≥ {{target}} on holdout + calibration plot + SHAP summary; decision memo with action tiers.
    M2 — Handoff & Monitoring
    Done =
    pipeline notebook + monitoring checklist.

Mobile (iOS Stability)

  • M1 — Upload Reliability
    Done =
    background queue with retry/backoff; metadata validation; TestFlight build + checklist.
    Out of scope: redesign, analytics overhaul.

These are “batteries-included” milestone planning upwork patterns that fence scope by design.

Grow Your Upwork Sales with Automation

Discover how GigRadar helps you send better proposals, get more replies, and win clients faster — no manual work needed.

Book a Demo

Estimation that resists creep (and protects margin)

Creep often hides in estimates. Protect yourself with these rules:

  1. Units, not hours. Sell outcomes (“Fix Pack & Validation”) with clear Done = …, not amorphous time buckets.

  2. 3-point estimates. Note best-case / most likely / worst-case; plan to the middle, buffer 10–15% for known unknowns.

  3. Assumption ledger. For each estimate, list the assumptions (access, tech version, data shape). If an assumption fails, route the delta through the change request template.
Real-world proof: see how an e-commerce growth agency used these same milestone and scope-control principles to generate $100k on Upwork in just two months with GigRadar.
👉 Read the case study

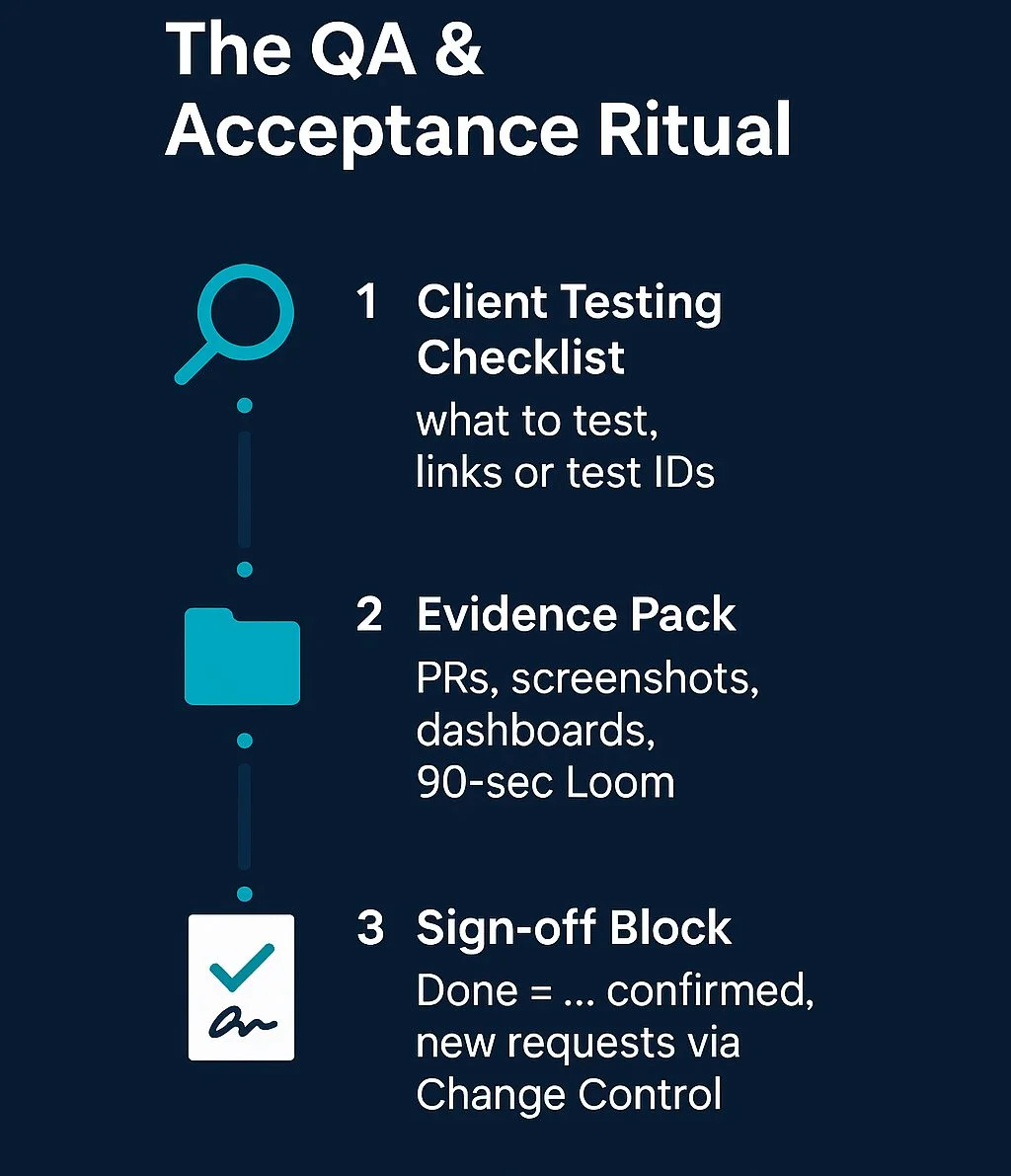

The QA & Acceptance Ritual (end creep at sign-off)

Never “assume acceptance.” Close each milestone with a crisp ritual:

  • Client Testing Checklist: list what to click/run (links or test IDs).

  • Evidence Pack: PRs, screenshots, dashboards, and a 90-sec Loom.

  • Sign-off Block (paste):

    Acceptance:
    I confirm the milestone meets Done = {{criteria}}. Any new requests will follow Change Control. — {{name/date}}

This 30-second step avoids 30-minute arguments.

While you’re tightening your scope control, don’t miss the other side of the funnel—how you bid. Manual vs automated bidding changes cost, speed and win rate.
👉 Compare approaches in this guide

Messaging snippets you’ll actually use

When the client asks for “one more small thing” inside the milestone:

Happy to include that. We can swap it for {{existing task}} (equal effort), or extend with a small follow-on milestone. Which do you prefer?

When a dependency slips (e.g., access delayed):

Flagging a dependency risk: without {{access/asset}} by {{date}}, our finish moves 1:1. If needed, we can add a micro-sprint to unblock via the change request lane.

When a vague request arrives:

To keep scope honest, can we translate that into Done = {{criteria}} for {{artifact/page}}? If yes, I’ll size it and propose swap / extend / explore options.

These lines preserve tone while enforcing the fence.

Anti-patterns (and the fix)

  • Time-named milestones (“Week 1”) → Rename by outcome.

  • No out-of-scope list → Add a 4–7 bullet “fence” to every SOW.

  • Unlimited revisions → One or two cycles; then change control.

  • Vague acceptance → Always include a bold Done = … line.

  • Feature creep during QA → Use the acceptance ritual; new items follow the CR lane.

One-week implementation plan

Day 1: Pick your two most common offerings; write Done = … lines in buyer words.
Day 2: Paste the SOW skeleton into your Upwork proposal template.
Day 3: Add the change request template to your snippets tool.
Day 4: Convert your current/next project into outcome-named milestones.
Day 5: Create an acceptance ritual (testing checklist + Loom + sign-off block).
Day 6: Train your team on swap/extend/explore language.
Day 7: Retrospective: note one clause that avoided creep; standardize it.

In a week, you’ll feel the difference: fewer “tiny” tasks, clearer progress, faster approvals.

Final Thoughts

Scope creep isn’t inevitable. With a clear scope of work upwork, outcome-named milestones, and a friendly but firm change request template, you turn “Can we also…” into structured choices. Adopt the clauses and blueprints above, and your upwork milestones scope creep problems become rare edge cases—not the story of every project. That’s how healthy milestone planning upwork feels: calm, decisive, and genuinely client-friendly.

Grow Your Upwork Sales with Automation

Discover how GigRadar helps you send better proposals, get more replies, and win clients faster — no manual work needed.

Book a Demo
Ready for your Upwork success story? Book a demo with GigRadar below!
Book a Demo
FAQ

Most Popular
Questions

Get a more consistent and cost-effective lead generator for your Upwork agency.

Ask a Question

What’s a good number of milestones?

For most projects: 2–4. Each should ship something testable and sign-offable.

Can I change scope mid-project without friction?

Yes—through the change request template. It formalizes new tasks and keeps the project honest.

What if the client insists something is ‘obviously included’?

Point to the Out of scope block and offer swap/extend/explore. Keep the tone helpful; give choices, not resistance.

Should I price milestones fixed or hourly?

Fixed plus Done = … wins more trust and prevents drift. Use hourly only for exploration (with a cap), then convert to fixed milestones.
